Page 119 - IRSEM_Main Book
P. 119

Para No. 5.1.2                                                                  Annexure: 5-A1

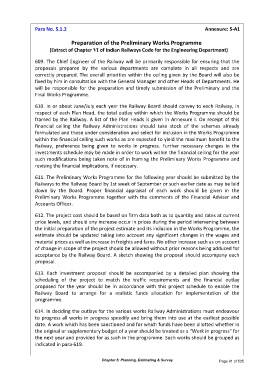

                                 Preparation of the Preliminary Works Programme
                       (Extract of Chapter VI of Indian Railways Code for the Engineering Department)

                 609. The Chief Engineer of the Railway will be primarily responsible for ensuring that the
                 proposals  prepared  by  the  various  departments  are  complete  in  all  respects  and  are
                 correctly prepared. The overall priorities within the ceiling given by the Board will also be
                 fixed by him in consultation with the General Manager and other Heads of Departments. He
                 will  be  responsible  for the  preparation  and  timely  submission  of  the  Preliminary  and  the
                 Final Works Programme.

                 610. In or about June/July each year the Railway Board should convey to each Railway, in
                 respect of each Plan Head, the total outlay within which the Works Programme should be
                 framed by the Railway. A list of the Plan Heads is given in Annexure I. On receipt of this
                 financial  ceiling  the  Railway  Administrations  should  take  stock  of  the  schemes  already
                 formulated and those under consideration and select for inclusion in the Works Programme
                 within the financial ceiling such works as are expected to yield the maximum benefit to the
                 Railway,  preference  being  given  to  works  in  progress.  Further  necessary  changes  in  the
                 investments schedule may be made in order to work within the financial ceiling for the year
                 such modifications being taken note of in framing the Preliminary Works Programme and
                 revising the financial implications, if necessary.

                 611. The Preliminary Works Programme for the following year should be submitted by the
                 Railways to the Railway Board by 1st week of September or such earlier date as may be laid
                 down  by  the  Board.  Proper  financial  appraisal  of  each  work  should  be  given  in  the
                 Preliminary  Works  Programme  together  with  the  comments  of  the  Financial  Adviser  and
                 Accounts Officer.

                 612. The project cost should be based on firm data both as to quantity and rates at current
                 price levels, and should any increase occur in prices during the period intervening between
                 the initial preparation of the project estimate and its inclusion in the Works Programme, the
                 estimate should be updated taking into account any significant changes in the wages and
                 material prices as well as increase in freights and fares. No other increase such as on account
                 of change in scope of the project should be allowed without prior reasons being adduced for
                 acceptance by the Railway Board. A sketch showing the proposal should accompany each
                 proposal.

                 613.  Each  investment  proposal  should  be  accompanied  by  a  detailed  plan  showing  the
                 scheduling  of  the  project  to  match  the  traffic  requirements  and  the  financial  outlay
                 proposed  for  the  year  should  be  in  accordance  with  this  project  schedule  to  enable  the
                 Railway  Board  to  arrange  for  a  realistic  funds  allocation  for  implementation  of  the
                 programme.

                 614. In deciding the outlays for the various works Railway Administrations must endeavour
                 to progress all works in progress speedily and bring them into use at the earliest possible
                 date. A work which has been sanctioned and for which funds have been allotted whether in
                 the original or supplementary budget of a year should be treated as a "Work in progress" for
                 the next year and provided for as such in the programme. Such works should be grouped as
                 indicated in para-619.



                                              Chapter 5: Planning, Estimating & Survey            Page 91 of 535
